Schedule

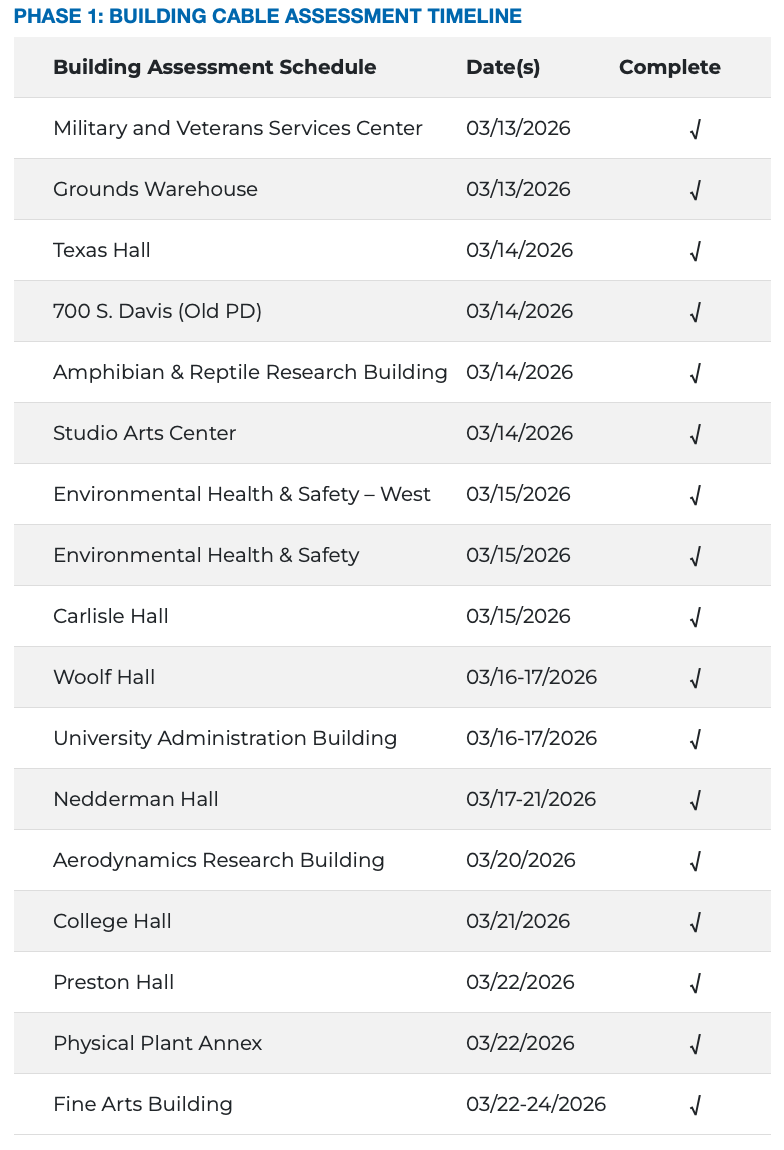

Phase 1
- Completed Spring 2026
Phase 2
- Installations: Beginning Summer 2026
- Phase 2: Building cable installation timeline
- Installation dates subject to change. Timelines will be updated as needed.
- Phase 2: Building cable installation timeline
- Program closeout and documentation: Summer 2027
Phase 2: Building cable installation timeline
| Cable Installation Schedule | Start | In Progress | Complete | |
| Studio Arts Center | Fall 2026 | √ | - | |
| 700 S. Davis (Old PD) | Fall 2026 | √ | - | |
| Ground Warehouse | Fall 2026 | √ | - | |
| Military & Veterans Services | Fall 2026 | - | - | |
| Environmental Health & Safety West | Fall 2026 | - | - | |
| Amphibian & Reptile Diversity Research Building | Fall 2026 | - | - | |
| Woolf Hall | Fall 2026 | - | - | |
| University Administration Building (UAB) | Spring 2027 | - | - | |
| Texas Hall | Spring 2027 | - | - | |
| Preston Hall | Spring 2027 | - | - | |
| Carlisle Hall | Spring 2027 | - | - | |
| College Hall | Spring 2027 | - | - | |
| Nedderman Hall | Spring 2027 | - | - | |
| Fine Arts Building | Spring 2027 | - | - | |
| Environmental Health & Safety | Spring 2027 | - | - | |
| Aerodynamics Research Building | Spring 2027 | - | - | |
| Physical Plant Annex | Spring 2027 | - | - |
